Works completed

Lot 3 renovations, 2002

Lot 3 was extensively renovated in 2002. It included major bathroom works including the removal of load bearing walls and the laundry. In the kitchen there was revised plumbing, a laminated floor and new kitchen cabinetry. Security gates were installed on all doors and some windows. The work was undertaken by m2design and Lot 3 also commissioned the Chapman Hutchison Report.

In 2010, further upgrades were made and all security gates were removed from doorways. A retrospective engineer's certificate was submitted to Council and in 2018 a retrospective Special By-Law was passed to make some of the renovations from 2002 lawful. The location of the laundry in the kitchen without waterproofing and floor drainage is still unlawful for any Class 2 building.

Incinerator & chimney stack repairs, 2004

Northrop's engineers specified the detailed works to repair the structural damage to the incinerator chimney in the rear lightwell area. This work had been identified by Chapman Hutchison. The chimney base was opened up to reveal a mass of lime and ash slurry that acted as a sponge for rainwater and caused rising damp and soft brickwork in the adjacent walls. The new enclosure was designed with a louvre door to act as a new boiler house, and this was used until 2013.

The work was designed by Northrop and undertaken by BSR Construction.

The rising damp and soft brickwork to the adjacent internal walls in Lot 1 was repaired in 2022.

Western boundary repairs, 2004


The steeply sloped land was cleared along the western boundary and damaged trees and failed retaining walls were removed prior to new terracing and planting.

About 40 new golden cane palms were planted and a new fence was installed along the entire strata  boundary at a later date. The large camphor laurel tree in the common property garden was not removed until 2017.

This work was undertaken by BSR Construction with funding from Lot 1 and strata. The terracing to the common property garden is still to be completed.

Lightwell facade repairs, 2005


The original gutters from 1994, or eariler, were too shallow for the amount of rain being collected from such a large roof. This meant that overflowing water was rotting the fascia boards. Where the rot was most prevalent was in the lightwell area where the roof valleys directed a higher proportion of the rainfall.



To address the recommendations in the Chapman Hutchison Report, the lightwell area was filled with scaffold and the gutters were removed. New fascia boards, soffits and deeper gutters were installed. An additional downpipe was also installed to help get the water away. The painted membrane was also renewed but the old calcimine base paint was not removed as part of the process (it was later removed in 2024 when the membrane was again renewed).

The work was undertaken by BSR Construction.

Southern storm water upgrade, 2006


A civil/hydraulic engineer was engaged to upgrade the storm water system ahead of a bedroom extension and new roof to Lot 1. This was part of Condition 13 in DA322/2004/1. The storm water and groundwater was directed through a new 150mm pipe and out to the kerb line on Manning Road.

At the same time a new sewer line was connected to an existing branch running under the foundations, and then extended to the boundary trap in 2015 via the driveway sewer system.

All work was undertaken by George Holovsky with funding from Lot 1 (cost $5,400). A Special By-Law covers these works.

Southern boundary repairs, 2006


The property boundaries are the responsibility of the owners corporation and the southern boundary walls relied on sandstone blocks that were either displaced or temporarily propped. Whilst retaining a sandstone theme, Alba & Associates designed a new boundary wall that provided a wider driveway to 15 Manning Road and gave more space for the planned additions to Lot 1 in 2007.

The work was paid for by Lot 1 in exchange for the exclusive-use of 2.6 metres of common property adjacent the southern gas meters (cost $19,000). The structural work was designed by Alba & Associates and constructed by George Holovsky. A Special By-Law covers these works in addition to a written consent from 15 Manning Road.

Lot 1 bedroom extension & second bathroom, 2007


The original courtyard to Lot 1 consisted of a small laundry out-house on the back of bedroom 3 and a large paved area.

The laundry was demolished and replaced with a larger room and walk-in wardrobe. A Special By-Law covers these works as well as the southern sewerage and storm water upgrade (2006) and the southern boundary repairs (2006). The gas meters were relocated and all regulators upgraded.

The work was designed by Dunn Architects and Alba & Associates, constructed by George Holovsky, and reviewed by Albert Zenere. All works were funded by Lot 1 (cost $111,695).

Southern and western facade repairs, 2007


In 2007 the entire southern and western facades were covered in scaffold to address the recommendations in the Chapman Hutchison Report. The eaves and gutters were replaced; all external structural cracking was filled with Sika grout; any failed lintels above windows were replaced; all plumbing was replaced; and, the entire facade was pressure blasted back to the calcamite covered roughcast render. The walls, windows and other timber were re-painted.

The work was undertaken by BSR Construction and reviewed by Albert Zenere.

The structural repairs to the inner leaf of the external wall were inspected and repaired in 2023.

Roof access, insulation and gable wall repairs, 2009

In 2009 access to the roof void was created via a new door and a NSW home insulation grant was used to insulate the roof void. The roof space was full of old tanks and cabling, and 80 years of black soot. Some of this was removed and 100mm of insulation installed together with some walkways and lighting. The lime mortar in the gable walls was badly eroded and so each gable was acrylic rendered on the inside.

The roof is still unlined (i.e. there is no sarking under the roof tiles) and so the black soot continues to accumulate and will do so until the roof tiles are replaced with sarking. However, the original terracotta roof tiles are in good condition and until these start to fail it is not an economic upgrade.

Lot 1 renovations (on hold from 2009)


These works are described in a second Special By-Law and commenced in 2008. The en-suite bathroom in the bedroom extension was abandoned and a Section 96 was approved by Woollahra Council for a new bathroom (to replace bedroom 2). However, in 2009 Lot 1 put these works on hold until the following had been completed:



1. Hot water system upgrade (completed 2013)

2. Extending the southern sewer line upgrade to the boundary trap (completed 2015)
3. Structural underpinning of the brick columns either side of the kitchen wall openings (completed 2015).

In 2019 the new bathroom to Lot 1 was completed as part of DA 322/2004/3 and a building certificate was issued by Woollahra Council.

Northern facade repairs, 2009


As recommended in the Chapman Hutchison Report, and consistent with the works to other facades, in 2009 the northern facade was covered in scaffold and the external structural repairs undertaken. Building movement on the northern side of the building is at greater risk than the southern side due to the underlying groundwater conditions. Sometime before 1994, the building dropped about 70mm on the northern side and this meant that the scope of structural repair was far greater.

The work was undertaken by BSR Construction.



The structural repairs to the inner leaf of the external wall were completed in 2023.

Eastern (front) facade repairs, 2010


Consistent with the Chapman Hutchison Report, in 2010 the external structural repairs were undertaken to the eastern (front) facade. The amount of building settlement on the right hand side was extreme, and much of the cracking required brickwork to be rebuilt. Failed clinker ash lintels to roof corbels and brick arches made this facade very challenging for repairs.

The work was undertaken by BSR Construction.

In 2021, Sydney Water filled a major void under a concrete slab in Manning Road and this has greatly reduced the vibration from large passing trucks on bin day etc. The structural repairs to the inner leaf of the external wall were completed in 2023.

Garage beam replacement & electric doors, 2011

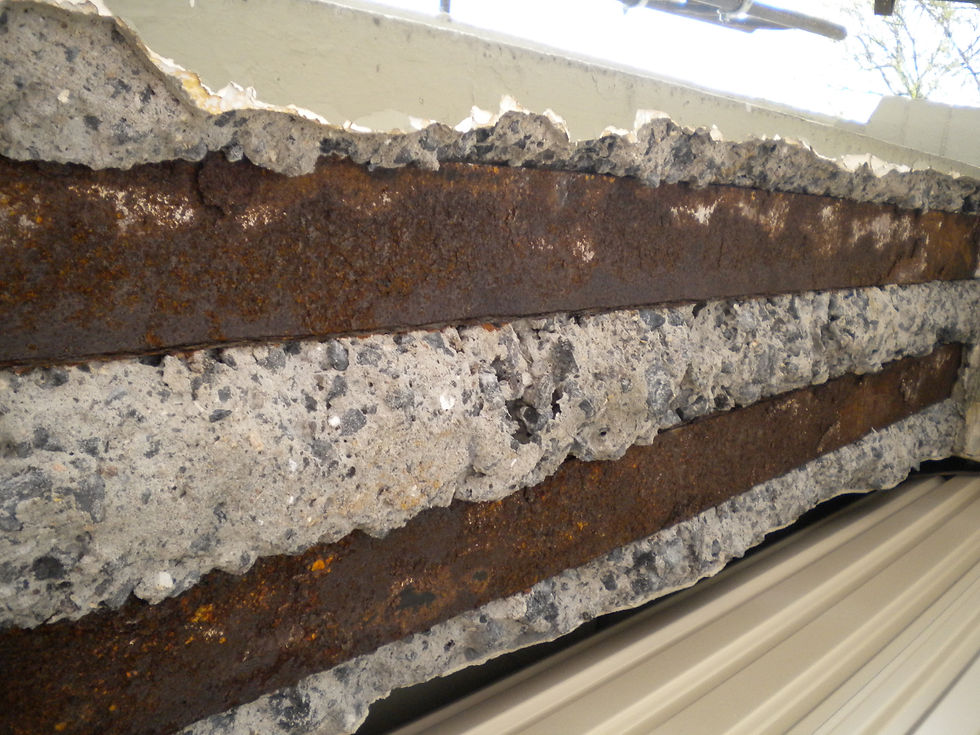

The garage door openings were deemed unsafe due to concrete cancer in the original beams.

A total of 8 galvanised steel beams were needed to rebuild the 4 door openings to Lots 2, 3, 5 and 6. This involved opening the asbestos ceilings in each garage to provide access for temporary wall props. The asbestos ceiling to Lot 5 was completely removed, but the painted asbestos ceilings to Lots 2, 3 and 6 still remain.

​The work was specified by R Balas Consulting and undertaken by BSR Construction. The electrification of the garage doors was undertaken by J&K Roller Doors.

Western retaining wall & drainage repairs, 2012


The failed retaining wall behind Lot 2 was identified by Chapman Hutchison in 2002, and removed in 2004. The offending tree was not removed until 2017. The area suffered from poor drainage and frequently flooded. Termites were discovered in Lot 2 in 2004 and the level of ground water infiltration was a key factor in attracting the ants to the area.

In 2012, a galvanised steel and timber retaining wall was built into the rock, and a new drainage sump with pump were installed.

The work was undertaken by BSR Construction and Hunter Metal Work. In 2023, the pump was removed and the drainage sump was connected to the stormwater system.

Hot water system upgrade, 2013


The original hot water system relied on a central boiler and a small bore return network to increase hot water response time. It had the ability to service about 18 persons in the building in peak times, and this was frequently stretched.

To upgrade the ageing system, each unit was provided with its own externally mounted gas boiler, together with a metered gas and water supply. All pipework was hidden inside 2 dedicated shafts inside the wall cavities. Individual unit boilers are Lot property in the Common Property Memorandum.

The work was undertaken by BSR Construction and Rubber Duck Plumbing.

Eastern (front) sewerage upgrade, 2015


The proposed landscaping to the front facade meant that the sewer line needed upgrading to avoid tree root invasion. It had also been identified by Chapman Hutchison in 2002 that the sewer lines needed investigating. Both these goals were achieved, in part, with this project. The 4 metre section of clay pipe under the entrance steps had to remain, but was lined by Pipe Relining Solutions using an epoxy sock and is covered with a 20 year warranty

The work was undertaken by Rubber Duck Plumbing with funding from Lots 1 & 5. The northern sewer line is still to be upgraded if any toilets are added to those Lots.

Electricity feed upgrade, 2015


A Level 2 electricity service provider upgraded the original 1928 supply cable to the building using a new 25mm 4 core XLPE service cable.



All meter panels were rewired to a new mains switch using 10mm PVC. Each unit is now limited to 50A and safety switches are fitted to all circuits. The only remaining 1928 cabling is in the lighting circuits of units 1, 2, 3 and 4, and the common stair area, but the use of safety switches minimises the risks from old cabling.

The Level 2 work was undertaken by Eris Electrical. The relocation of circuit breakers for each unit into Lot property, and the extension of the 10mm PVC cable into each Lot, has still to occur.

Cement injection to eastern (front) facade, 2015


A cement injection technique was instigated as part of a Special By-Law whereby a superfine cement mix was injected into the ground to a depth of 2 to 3m, and this delivers a tensile strength of 5 to 10 MPa.



The work was initiated to safely permit the structural underpinning to the southern side of the building, but was extended to the eastern (front) elevation to stabilise the ground against future movement caused by changing ground water conditions. The load-bearing capability of the ground is not changed.

The work was inspected by R Balas Consulting and undertaken by GFW Australia, with funding from Lots 1 & 5.

Structural underpinning to southern side, 2015


Although underpinning was not considered cost effective by Chapman Hutchison, it does provide a permanent solution to footing movement if the rock and water conditions permit it. It also becomes a necessity if the load bearing structure is being altered near known footing movement, as in the case of the works described in Special By-Law 2.



To make the underpinning cost-effective, a 40cm deep sub-floor void was offered to all owners as a potential storeroom on the condition that whoever took up the offer underpinned the southern side of the building. Special by-Law 7 covers these works.

The work was specified and inspected by R Balas Consulting and undertaken by ADS Underpinning & Piering, with funding from Lots 1 & 5.

Driveway repairs & landscaping, 2016


The driveways were raised as a concern by Chapman Hutchison in 2002, and so after upgrading the eastern (front) sewer line and electricity feed the driveways to Lots 2, 3, 5 and 6 were excavated and road base added and compacted to new levels. The new concrete slabs were poured to a depth of 200mm using SL82 mesh and 32 MPa charcoal concrete.

Openings in the concrete were provided for planting 8 x Magnolia grandiflora "Kay Paris" and 160 x Buxus microphylla "Japonica". Provision was also made for Hunza lighting and Galcon irrigation.


The work was designed by Bay Street Gardens and R Balas Consulting, and undertaken by City Concrete, TM Services and Plantbiz.

Second bathrooms
Second bathrooms (stalled in 2018)



Second bathrooms (DA53/2016) rely on new drainage for sewerage and stormwater, as well as gas, electricity and cold water supplies passing through the courtyard of Lot 2 (property which can extend 3m below ground).



The depth of this new drainage is a function of the foundation design for Lot 2's extension (DA32/2017), which together with their own drainage design needs to be approved by Council before anything can be built.
All owners are reliant on Lot 2 to install the drainage needed for the second bathrooms without compromising their own development.


However, in 2018 the compulsory manager passed a Special By-Law for Lot 2 that excluded any drainage, and this effectively blocked the plan for second bathrooms.

Roof truss sagging, 2022



In the Chapman Hutchison Update in 2018 it was identified that the timber to timber connections to the roof framing were moving as a result of the 1928 wrought iron nails rusting in the humid roof environment. The structural engineer specified "triple-grip" connectors and new galvanised nails. After further inspection, the proposed solution by the roofing truss carpenters was to add some additional timbers (called collar ties) and also use galvanised bolts instead of nails.

NCAT Orders dated 7 July 2022 (SC22/14942) ensured that twenty-six timber collar ties were added together with new props (the original roof was built with only 7 collar ties) and 70 galvanised bolts were added. Safe access platforms were also installed for NBN, FTA TV, roof vents, etc.



All works were completed by Chippys Carpentry.

Internal structural repairs, 2023

The structural repairs needed to internal walls and the inner leaf of the cavity wall were as a result of roof movement and building settlement.

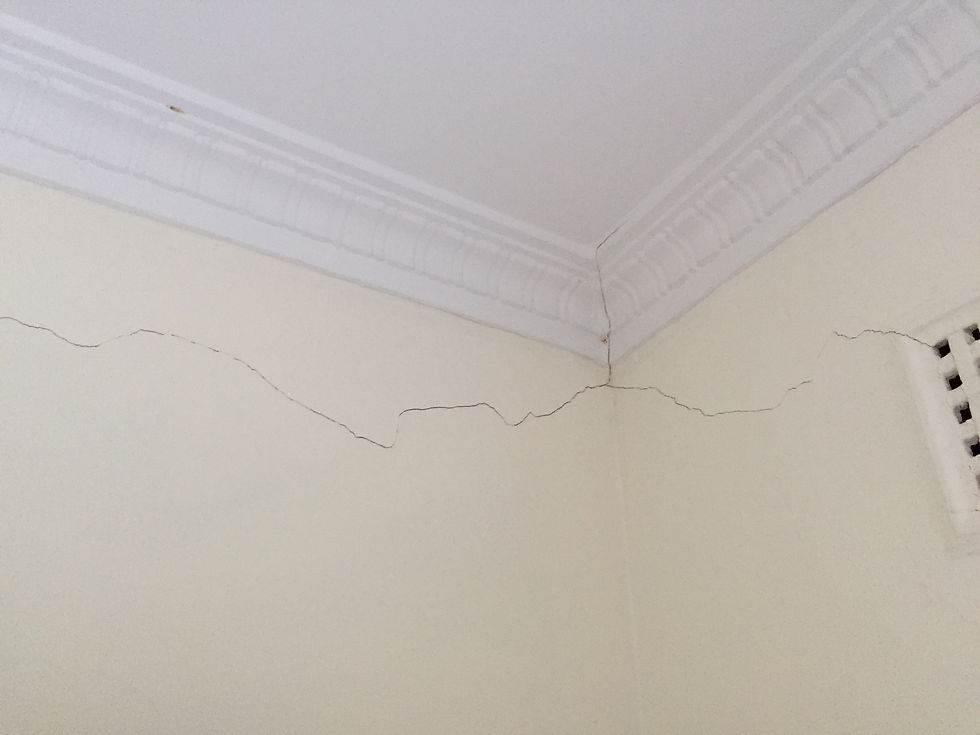

The roof movement caused cracking and displaced cornices in the upper part of the walls in the top two units – this repair work was executed as part of NCAT Order SC22/14942.


The cracking from building settlement was either as a result of the major drop under units 2, 4 and 6 sometime prior to 1994, or through changing ground water conditions which are more pronounced along the northern facade. An inspection of all internal plaster finishes adjacent to the internal lintels above windows and doors resulted in minor repairs as most of the major works had been completed in 2007 and 2010. All works were completed by Plasterfix.

Northern drainage repairs, 2023

The stormwater system along the northern facade had been temporarily repaired in 2010 with a large section relocated above ground. This temporary measure was undertaken as the two proposed developments in the area (DA32/2017 and DA53/2016) both required the replacement of the 4" system with a new 150mm pipe to the kerb in the street.


In 2023, both DA's had expired and so the existing 4" clay pipe system was repaired and reconnected. The sump pumps to the retaining wall behind Lot 2 were also removed and some sections of the original system were sleeved with an epoxy lining to manage tree root infiltration through the clay pipe connections.

All drainage repairs were completed by Howard Plumbing and the relining was completed by Sydney Relining.

Window sash upgrade
Window repairs (2024)


The windows were raised as a concern by Chapman Hutchison in 2002 and repainted between 2007 and 2010 with new timber quadrants adjacent the brickwork.



In 2024/25, the building was again covered in scaffolding and the windows were stripped and repainted using the Norglass Northane 2-pack paint system. As part of the preparation, the sill corners were checked for rot, any cracked glass was replaced, the putty and sash cords were replaced where necessary, sikaflex 11FC was used to seal brickwork and timber joints, and the top sash was permanently secured. The damaged sills from the old window boxes adjacent units 2 and 4 were repaired using sikaflex 11FC. Some owners also took steps to temporarily upgrade their window safety devices ​using a compliant subframe system.

All works were completed by TAK Projects.

Membrane repairs (2025)


To abate the influx of rainwater into the structure, the building membrane was renewed between 2005 and 2010 as part of the staged works to each facade. The Dulux specification relied on water blasting to remove the old calcimine base paint, X10 Weathershield as a primer, and AcraTex AcraShield as a top coat.

In 2024/25, the building was again covered in scaffolding and a new membrane was applied to all walls. The last remaining section of the old calcimine paint in the lightwell was removed beforehand. With the scaffolding in place all external lintels were inspected by engineers as well as the two outward facing roof corbels on the eastern elevation as they were not accessible in 2010. The membrane system was from Taubmans.

All works were completed by TAK Projects.

Engineer's inspection (2025)


Since 2002, two engineers have principally supported the progress of works at 13 Manning Road - Chapman Hutchison and R.Balas Consulting

Chapman Hutchison provided reports in 2002, 2018, 2019 and various reports in 2022. The Directors of this firm have since retired. R.Balas Consulting has been used for most of the design and staged inspections of works since 2006, including the garage steel beams, concrete driveways, underpinning, retaining walls, drainage and any Council certification.

In 2025, R.Balas Consulting provided a letter of completion for the various reports issued by Chapman Hutchison in 2022 and undertook an inspection of the building whilst the scaffolding was in place to confirm the condition of the lintels, external membrane, roof and stormwater drainage.
